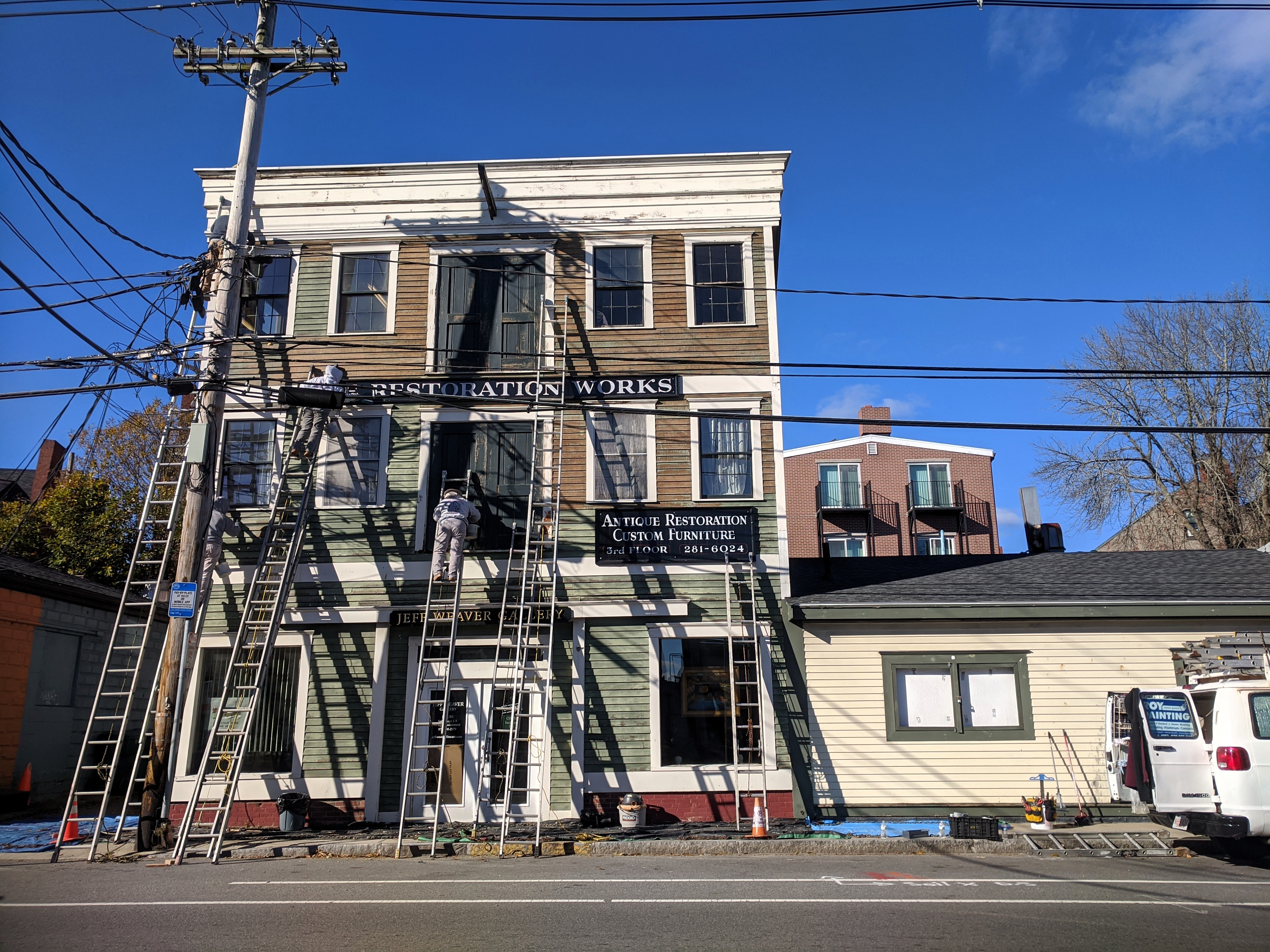

photo: Shadows, ladders and lines. Workers hand scrape and sanding Restoration Works building facade, 16 Rogers St., Glouc., MA., on Nov. 20, 2023
My View of Life on the Dock

photo: Shadows, ladders and lines. Workers hand scrape and sanding Restoration Works building facade, 16 Rogers St., Glouc., MA., on Nov. 20, 2023

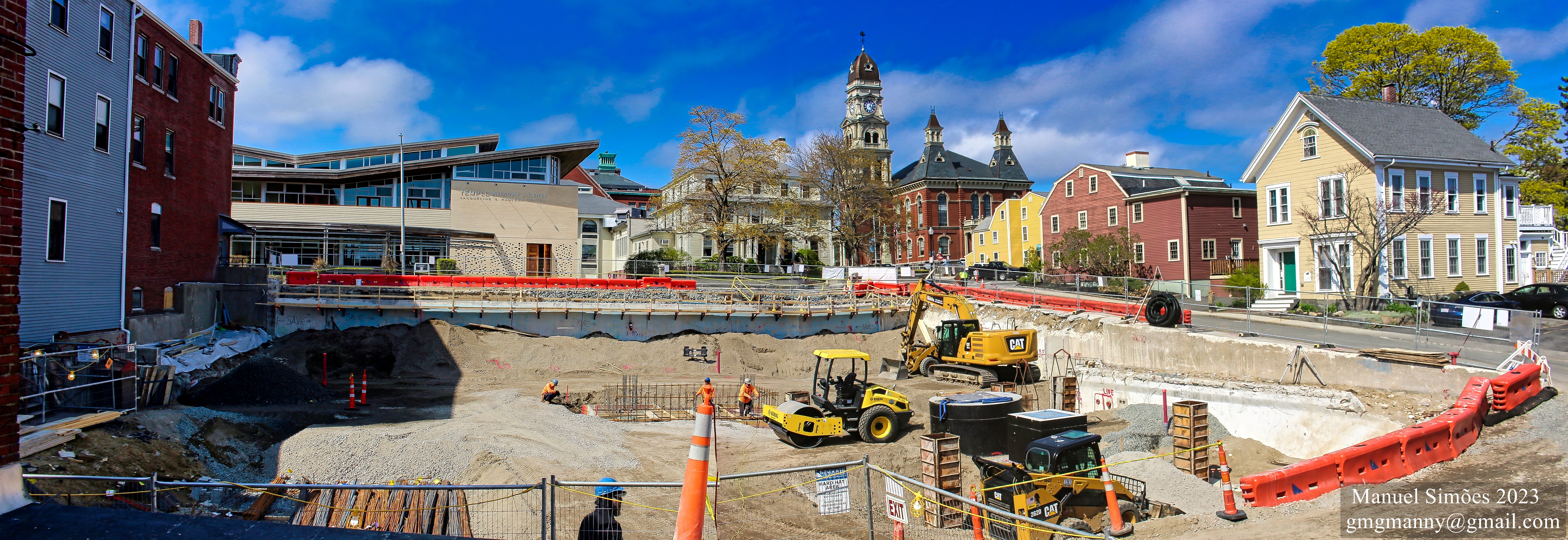

New construction downtown.
I don’t know if this is the original applicant. Construction underway at Whistlestop Way near Doyon’s, between Dollar General and Auto Parts, where Google maps is labeled, ‘Family Dollar’. The new sign is ‘Ocean Breeze Craft Cannabis’




Answers

Construction news.
Chase is opening hundreds of branches in local communities including in Gloucester in one of the anchor buildings comprising Walgreens Plaza downtown. The firm renovating the structure for a flagship bank, in a space originally built out for a now shuttered Papa Gino’s restaurant, has built many for Chase already. The branch is located next to Dunkin’ Donuts and across from the Santander branch that opened in the yogurt store. It’s expected to open by January 2024.




Responses to questions I’ve received about more construction:
The crane above and behind Walgreens is for renovation happening at police headquarters.

Further afield: not sure, but assuming the dig out by Thatcher Road condos is landscaping and it looks like a path (out back?). The sidewalk/path below grade that flooded and iced over was removed and a new sign added.


















If you stop to think about how many projects Gloucester’s DPW is pulled into that they may not have spearheaded but must deliver and complete, all the while doing their essentials, it’s no wonder other Public Works look at what Gloucester’s DPW provide and think they do a model job.
For permanent infrastructural projects (see Stacy Boulevard series) it’s evident that form and beauty are taken into consideration as much as possible.
There’s a lot more green in the GHS Flood Control Project 2023 since the last photographs I posted a month ago. More plantings and landscaping coming will add even more appeal. New trees were laid this week.
“Construction went smoothly. With permanent infrastructure it’s tricky to balance form over function. Form is so, so important! To me. To the City. To the residents. I always try to strike a balance.”
Mike Hale, Dir. DPW, Gloucester, MA
Diagonals and lines are incorporated into the landscape elements and the zig zag, tapered wall itself which is wide enough–by design for its purpose–and that someone climbing, sitting, or walking on top is not hurt. Final rounds of hydro seeding should be finished by Friday. Crews are working on “small stuff and finishing touches”. Removal of equipment like the mini excavator are scheduled for Monday.
At this stage in the project, the grassy walk is wide and welcoming and the Annsiquam humming with activity. Two geese sauntered past unbothered. Maintaining public space and green additions are evident. The old preschool at the highschool’s playground equipment is enhanced and feels upgraded to a waterfront walk and park that’s as fun to visit as Cripple Cove. With 1000 less enrolled at GPS there’s ample room at GHS for relocating the preschool and school administration from Blackburn back into the highschool. There might even be room for the Pond Road or other city offices. They can make use of an enhanced amenity. When this community space opens there’s a full circle longer walk option around the school: from Dun Fudgin/Emerson, back of school, bit of Centennial to the riverwalk.
The public can resume access to the riverwalk along the ‘squam between the Cut and Dun fudgin’ next week. There are three ways to walk on: 1)to the right of the bridge tender from Stacy Boulevard, 2)from the high school (by the softball field), and 3)Dun Fudgin’. The bridge tender is city property; they lease it from the city. If you check out the progress before Tuesday, you can see the temporary fences and locked gates which will be removed.




**Managed and partially funded by City of Gloucester, DPW**
Managed: City of Gloucester DPW
Engineers: GZA GEO Environmental, Amesbury
Contractor: Charter Contracting Boston
Status: nearly across the finish line.
Progress: as of June 21, 2023 completion ETA is Monday June 26, 2023. Gates open Tues.
Project start (historic): pre 1900
Modern project start: on the ground January 2023
Funding Awarded by:
Bid Open and contract amount: 3.244M
Contract completion: 2023
Locations: Along ‘Squam length between cut bridge and dun fudgin
Priority: 1,439 linear feet of flood wall necessity, for safety and continued investment along an area the city has developed since the landfill late 1800s, and longer related to the Cut. Infrastructure project with quality of life benefits for residents and visitors. Rather than traditional loud pneumatic pile driving, special drive sheets were fabricated to offset the noise (essentially vibratory)
Temporary work site chain link fence: Required. The chain link fence is installed by the contractor to protect the work zone and define it better. Will be removed as soon as possible.
High Res plans here
Directly across the river, construction for another wall encircling the city’s wastewater treatment facility is nearly finished. That project includes deployable gates for overflow.
The city’s investments in infrastructure is not new nor its evergreen commitment to improvements.
Fiscal year 2023 the City’s proposed budget is 133.9M. The DPW budget is about 32.1M million. For comparison, the school budget is about 50M*, 60% more. If we want more services or faster, money is another piece of the form vs. function balancing act.
*50M base number excludes: facilities rental for preschool/admin at Blackburn, etc.; school choice out tuition costs; Essex Tech expenditure; new school project; and special budget supplemental request/loan orders (e.g. school portion of 2.15M IT)





DPW did not install the greenhead boxes in Gloucester. In the photos above you can see greenhead boxes added to the salt marsh here as well as the new ones behind Good Harbor Beach. The Commonwealth’s Northeast MA Mosquito Control installed 58 traps. Last year it was 20. There’s a history of mosquito AND greenhead control combined action plans by the state which I wrote about here when I saw the new Good Harbor ones. I will add to that list an article by Ethan Forman who wrote about Essex and Wingaersheek and the city considering reenrolling. See Gloucester Daily Times here. That article mentions board of health asking city council for greenlight for the greenheads (each box about $90 a piece and a 3 year contract).
I will try to find a map or list of site locations. In the recent past I remember them in the marsh behind Lobsta Land. Apparently there were a fleet of them in the 1980s. Do you remember seeing them in more places at that time or were you involved back then? I’d love to learn about any tallies and sites and compare with 2023.





Link to post by Catharine in 2019 for old photos of area https://goodmorninggloucester.com/2019/10/16/sam-novello-asks-gmg-what-happened-to-the-cannons-at-stage-fort-park/






Next step underway – Gloucester DPW conveys that a textured surface for easier tread is being applied today. The pass through is a work in progress.

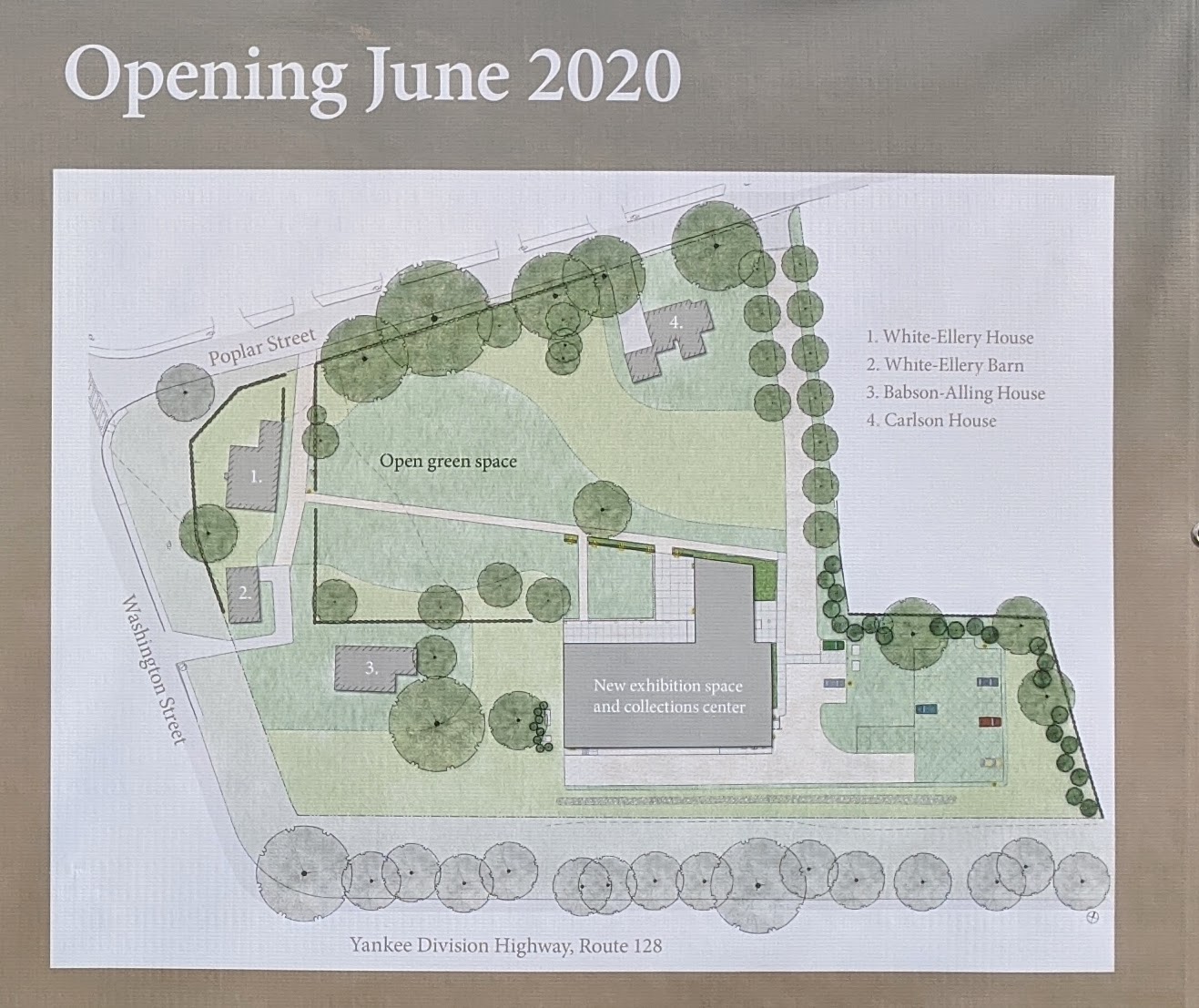

From Washington & Poplar streets, progress views (2018-2020) across to the Cape Ann Museum expansion. This spot includes the historic White Ellery House and Barn, Babson-Alling home, new archives & collections building, and public space and grounds. The museum’s anchor location is nearby on Pleasant Street in downtown Gloucester.
Apri 2019 / Nov 2019
Jan 2019 / Jan 2020
Nov 2018 / Jan 2020

The exterior transformation by RePro General Constuction & Design Services (ReProservice.com) for Danielle and Carlo Berdahn’s new Mediterranean bistro, Yella on the Water, is moving right along (in the former Morning Glory space) on Stacy Boulevard.
Before (2013) vs. construction underway (May 2019)


They opened Yella Grille in Andover (and catering) ten years ago.

A new mini marsh promenade is underway along Thatcher Road from Gloucester’s Good Harbor Beach entrance all the way around to the foot bridge. Walkers will have safe access via sidewalks and a natural path.
Gloucester has been planning for an opportunity to extend safer pedestrian access along Thatcher Road for years. When National Grid scheduled replacing antiquated gas lines along the busiest and scenic stretch, Gloucester Public Works was ready to seize the opportunity with collaborative solutions sensitive to conservation. Sidewalk upgrades were built out at both ends and paused until National Grid completed its underground infrastructure work. Prior to paving, Thatcher Road will be widened slightly to accommodate a safe and scenic path. The city hoped to complete repairs and paving by autumn and is on track to meet that goal. This week crews were clearing brush. The rusty guardrail was removed and will be replaced with a new design. “It will all happen quickly now,” says Mike Hale, director of Public Works.


Thatcher Road Under Construction

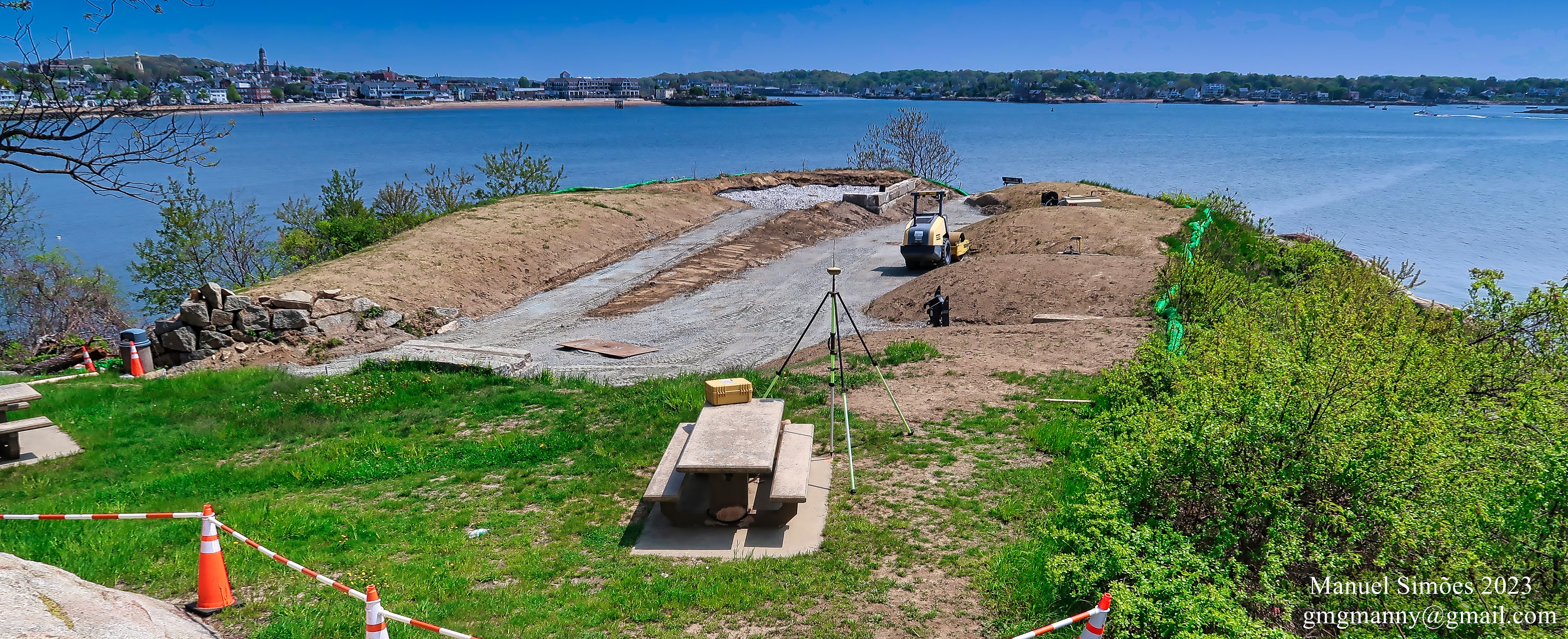

There’s an ideal and creative scenic overlook solution over the river that’s under construction off site. I can’t wait for the reveal! I have been documenting progress and will post various updates, fast stats and history as another impressive project moves along.


Gloucester’s great marsh walk will afford safer access for sweeping seasonal observation
winter, spring, summer, fall
One of my favorite Gloucester motifs, Gloucester oxbow, view from Thatcher Road

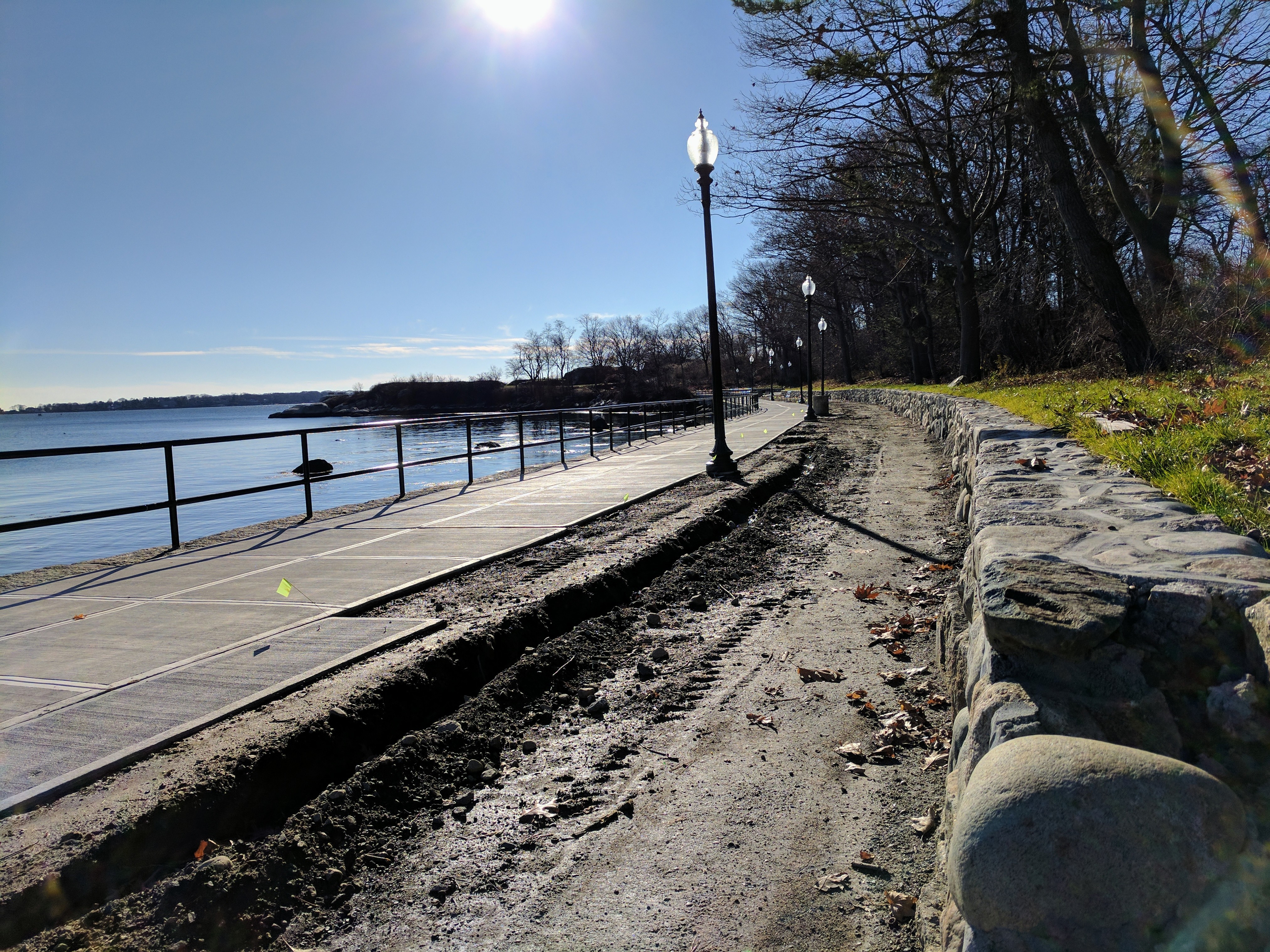

Earlier posts outline the engineering. The photograph above details the subgrade that was re-established for irrigation (note ditch alongside walkway), loam and sod. The photo also emphasizes the lengthy short wall on the right which was removed for access during construction. “The excavation was deep enough that the angle of repose was into the old wall.” The wall in the photo is rebuilt.

Spacing and symmetry were important design considerations for Stacy Boulevard construction. The old benches were surveyed. Most were returned relative to where they were sited before the build out. The memorial benches on the boulevard are full. This one shows a tribute to Al Swelka.

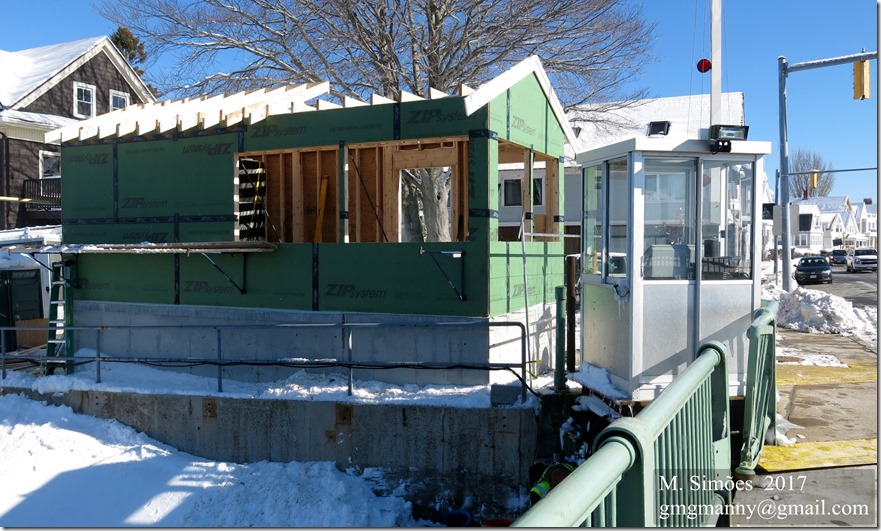

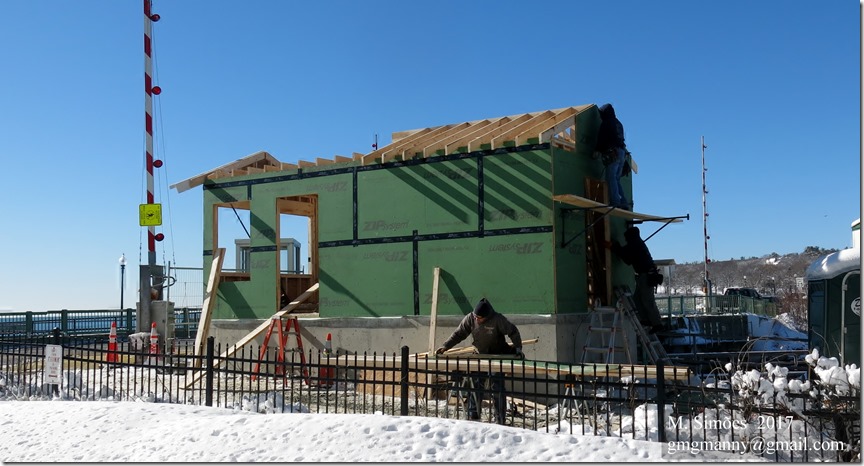

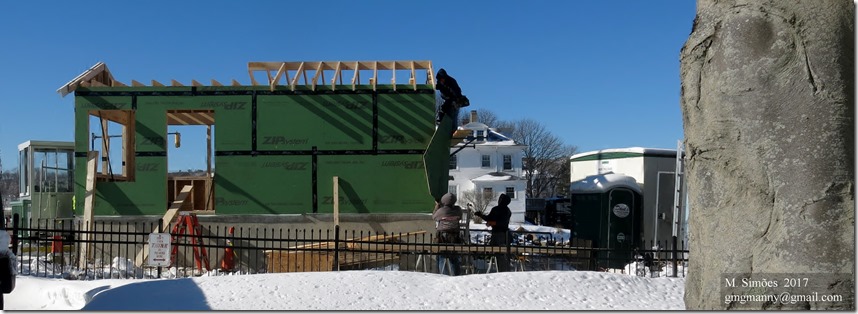

Photos Nov-Dec 2016. Video caption: Stacy Boulevard construction minute – stroll before January, and sod. Upcoming posts in this Stacy Boulevard series include: disasters, the cultural landscape, and Blynman.
Series:
Part 4 – Gloucester’s majestic public works construction stats: bringing the Stacy Boulevard plans to life
Part 2: Stacy Boulevard Public Works stunner | Gloucester is an early client for the Harvard and Olmsted trained landscape designer, Thomas Warren Sears. His 1908 photos are a must see!
STACY BOULEVARD NEARING THE FINISH LINE Part 1 – Walk this way: Gloucester’s stately Stacy Boulevard public works project is breathtaking and one for the ages!

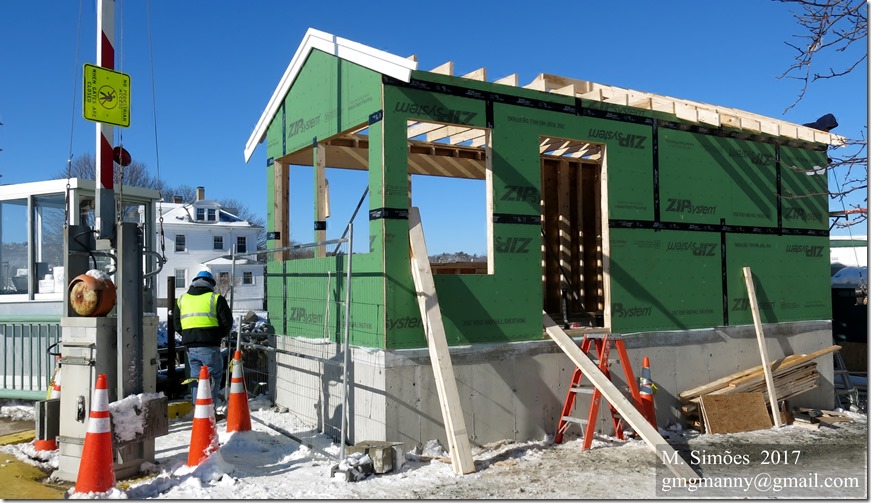

September 12 2016- Stacy Boulevard construction update: historic Blynman the Cut Bridge project scope plans and engineering details
August 2016 Stacy Boulevard construction details. Gloucester DPW is impressive
